OVER FLOW MODEL

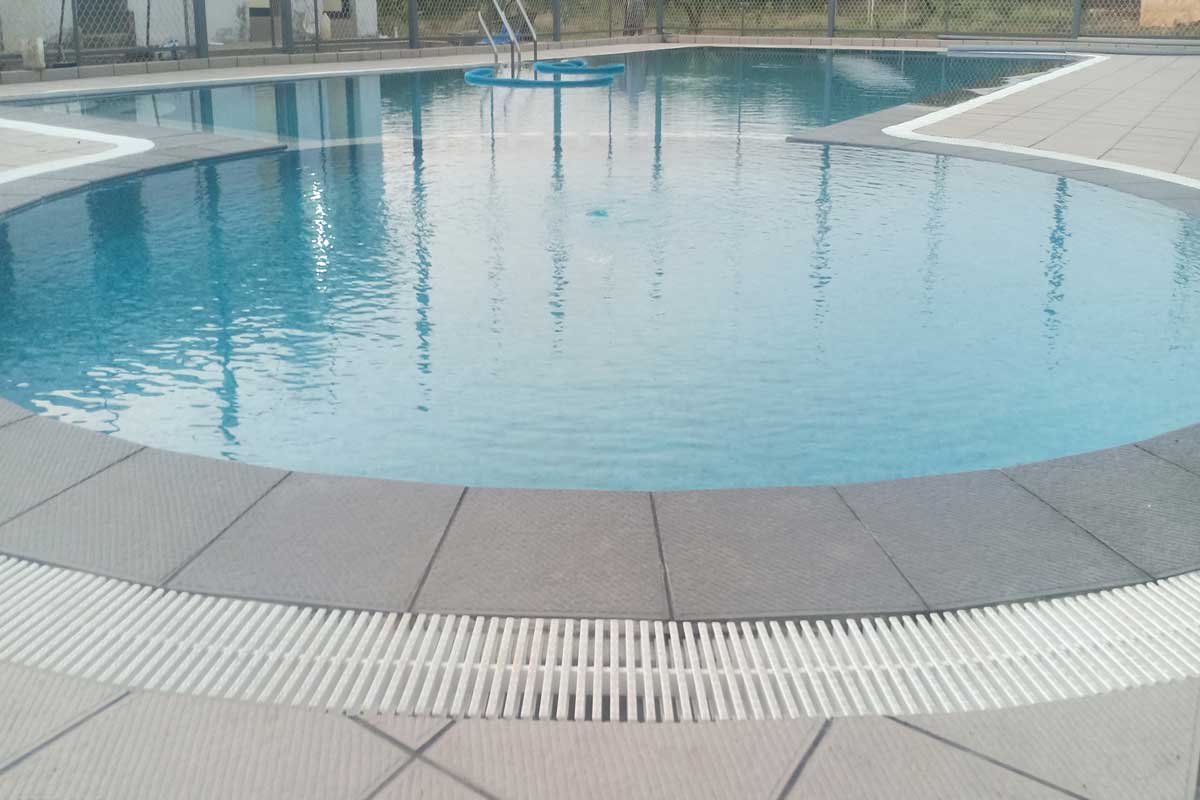

Over Flow model swimmingpool


SEQUENCE OF OVERFLOW MODEL POOL WORK

THE FOLLOWING LIST DETAILS THE PHASES OF POOL CONSTRUCTION:
  • PREPARATION OF DRAWINGS AND POOL CIRCULATION.
  • MARKING.
  • EXCAVATION FOR POOL AND BALANCING TANK.
  • PROVITION FOR POOL DRAINS AMD INLETS.
  • PLAIN CEMENT CONCRETE BASE WITH 40MM METAL (1:4:8).
  • FIXING OF POOL DRAIN AND INLET PIPES.
  • STEEL REINFORCEMENT FOR MAT CONCRETE.
  • POOL AND BALANCING TANK MAT CONCRETE WITH SUPER PLASTICIZER.
  • PROVITION FOR VACUM POINT AND LITE CONDUTES IN WALL CONDUTES.
  • WALL SHUTTERING.
  • POOL AND BALANCING TANK WALL CONCRETE WITH SUPER PLASTICIZER.
  • PROVITION FOR OVERFLOW CHANNEL.
  • ORDER PLACEMENT FOR TILES AND COPING STONE.
  • 5 DAYS CURING AND LEAK TEST.
  • PRESSURE GROUTING FROM OUTSIDE WALL IF YOU SAW ANY LEAKAGE.
  • APPLICATION OF POLYMER MODIFIED CEMENTITIOUS WATERTIGHT COATING PLASTERING WITH SUPER PLASTICIZER.
  • PUMP ROOM AND BALANCING TANK ROOF CONSTRUCTION.
  • CONNECTING PLUMBING BETWEEN PLANT ROOM AND POOL.
  • BACK FILLING AROUND POOL IN ONE FEET LAYERS AND PERFECT CONSOLIDATION.
  • PUMP ROOM ELECTRIC POWER SUPPLY.
  • WASTE WATER DRAINAGE ARRANGEMENT FROM PUMP ROOM.
  • FIXING OF LADDERS AND OVER FLOW GRATTINGS.
  • FIXING OF HAND RAILS.
  • COPING STONE LAYING ON THE TOP OF POOL WALL.
  • POOL TILE LAYING WITH TILES ADHESIVES AND SKILLED LABORS.
  • INLET , DRAIN COVER, VACUUM FITTINGS & UNDER WATER LIGHT FIXING.
  • INSTALLATION OF FILTER WITH FILTER MEDIA , PUMP, STARTER.
  • SWIMMING POOL CLEANING AND WATER FILLING.
  • TRIAL RUN AND POOL MAINTENANCE TRAINING.
  • SWIM IN YOUR NEW POOL.
